The Measured Change Strategy

Test and improve a business workflow before buying software. Use six practical stages to map the process, run a pilot, measure results, and reduce risk.

The Measured Change Strategy β€” a six-stage workflow adoption loop: Observe, Map, Pilot, Measure, Adjust, Stabilize.

Improve the Workflow Before You Buy the Software

Most software purchases are really workflow bets in disguise. A team feels friction, a vendor offers a confident demo, and the organization buys a tool to fix a problem it has never actually mapped. The tool usually works exactly as advertised β€” on the vendor’s clean data, against the vendor’s tidy example. It’s the organization’s own undocumented handoffs, inconsistent data, and unclear ownership that the demo never had to survive.

The Measured Change Loop is a six-stage workflow improvement framework for testing a process change on a small scale before a software purchase, automation project, or full rollout. It combines workflow analysis, process mapping, pilot testing, and measurement in one repeatable cycle. It doesn’t eliminate the decision to buy software. It postpones that decision until there is enough evidence to make it responsibly.

Use this loop when you’re looking at one specific workflow β€” not a department, not “operations,” not “how we do sales” β€” and you want to know whether a proposed change actually works before you commit budget, headcount, or a platform migration to it.

What This Framework Helps You Do

  • Document how a business process works today, including informal workarounds.
  • Find handoff, ownership, and data-quality problems before they are automated.
  • Design a small workflow pilot with a clear scope, owner, and baseline.
  • Measure whether the change improved the process and what new friction it created.
  • Decide whether the workflow is ready to scale, automate, or support a software purchase.

The Six Stages of the Measured Change Loop

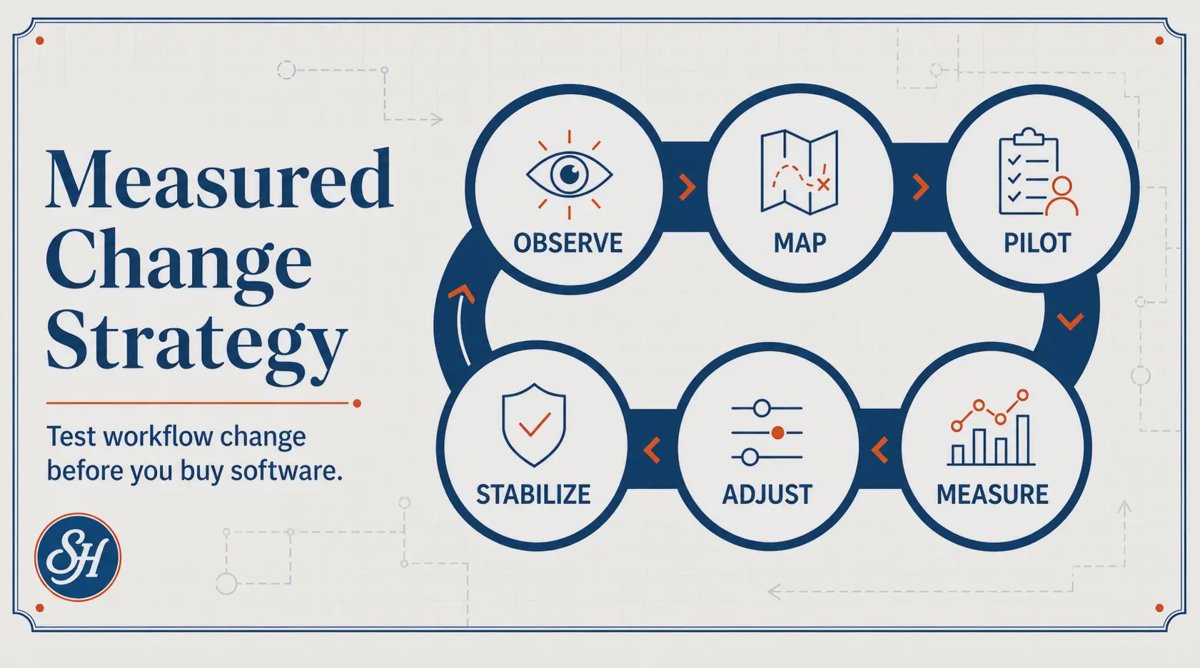

The Measured Change LoopSix stages in two rows: Observe, Map, Pilot, then Measure, Adjust, Stabilize, with a small dashed arrow between Measure and Adjust marking that pair as repeating two to three times, and a larger dashed arrow looping back from Stabilize to Observe to show the loop restarts for the next change.ObserveHow work happensMapHandoffs, ownersPilotOne small changeMeasureFriction, adoptionAdjustAct on feedbackStabilizeDocument then scaleΓ—2–3↻ Scaling, automating, or the next change restarts the loopGray = understand first Β· Teal = test cycle Β· Purple = lock in before expanding

The loop has six stages. Each has a core question to answer and an exit condition that has to be true before moving to the next stage. Skipping a stage doesn’t save time β€” it just moves the risk downstream, usually to the point where it’s expensive to find.

1

Observe

Core question: How does this work actually happen today β€” not how it’s supposed to happen?

Exit condition: The team can describe the current workflow in plain language, with numbers, and the people doing the work agree it’s accurate.

2

Map

Core question: Where does the work hand off, where does it stall, and who owns each piece?

Exit condition: Every handoff has a named owner or a documented gap, reviewed by the people closest to the work.

3

Pilot

Core question: What is the smallest version of this change that will teach us the most?

Exit condition: The pilot has a start date, an end date, a named owner, a one-sentence scope, and an agreement on what gets measured β€” before it begins.

4

Measure

Core question: What did the change actually do β€” including what it broke?

Exit condition: The team can say, with numbers, what improved, what didn’t, and what new friction appeared. “It seems better” doesn’t pass.

5

Adjust

Core question: What does the feedback say to change before going further?

Exit condition: The adjustment addressed the measured friction, the next measurement confirmed it, and the people doing the work agree it’s better β€” not just different.

6

Stabilize

Core question: Is this workflow solid enough to scale, automate, or build on?

Exit condition: The workflow is documented well enough for someone new to run it, it has an owner, and the next decision β€” scale, automate, or leave alone β€” is made deliberately.


Why It’s a Loop, Not a Line

The name is literal. A single pass rarely goes Observe β†’ Map β†’ Pilot β†’ Measure β†’ Adjust β†’ Stabilize in a straight line β€” Measure and Adjust typically cycle a few times before the workflow earns Stabilize. And Stabilize isn’t a finish line. Scaling the workflow, automating a piece of it, or expanding it to a new team is a new change, which means it starts a new pass through the loop β€” usually a much faster one, because Observe and Map have less to discover the second time.

The loop is also intentionally narrow. It’s built for one workflow and one change at a time. “Transform customer service” or “fix reporting” isn’t a change you can Observe β€” it’s a department-level objective. Break it down until you have something you could describe finishing in a sentence, then run the loop on that.


Worked Example: One Pass Through the Loop

The Situation

A small distribution company β€” about fifteen employees β€” is losing its sales team to the telephone. Customers call and email constantly asking the same question: “Where is my order?” Every inquiry sends a salesperson digging through the accounting system, a shared spreadsheet, and a buyer’s inbox to piece together an answer.

Leadership’s first instinct is a familiar one: buy customer-notification software. Automated emails, a customer portal, maybe a tracking page. Several vendors offer exactly this, and the demos look great.

Instead of starting with the tool, the company runs one pass of the Measured Change Loop on one change: getting order-status information to customers before they ask.

Note what the change is not. It is not “fix the supply chain,” “replace the accounting system,” or “transform customer service.” One workflow, one change, one pass.

Observe

Core question: How does this work actually happen today β€” not how it’s supposed to happen?

For two weeks, nobody changes anything. The sales team simply keeps a tally sheet: every status inquiry, who asked, and how long the answer took to assemble.

The tally shows 47 status inquiries in two weeks. More telling than the count is the texture. Answering an inquiry takes anywhere from two minutes to half a day, and the difference has nothing to do with the customer or the salesperson. It depends on whether the vendor supplying that order ever confirmed a ship date.

Exit condition: The team can describe the current workflow in plain language, with numbers, and the people doing the work agree the description is accurate. Not “customers call too much” β€” but “47 inquiries in two weeks, and the slow ones share a cause.”

Map

Core question: Where does the work hand off, where does it stall, and who owns each piece?

The team sketches the path an order’s status information travels: customer order entered in the accounting system β†’ purchase order sent to the vendor β†’ vendor confirmation β†’ ship date recorded β†’ customer informed. Then they mark what actually happens at each handoff.

The map exposes the real problem, and it is not a notification problem. Roughly a third of open orders have no confirmed ship date, because some vendors never acknowledge purchase orders and nobody owns chasing them. Confirmations that do arrive land in one buyer’s inbox and get typed into the spreadsheet “when there’s time.” The sales team isn’t slow at answering customers. It’s answering questions the data can’t support.

This is the finding that would have sunk the software purchase. An automated notification system pointed at this data would have confidently emailed customers ship dates that were guesses β€” automating the inaccuracy and mailing it out on schedule.

Exit condition: Every handoff on the map has a named owner or a documented gap, and the people closest to the work have reviewed the map and agree it reflects reality β€” including the workarounds.

Pilot

Core question: What is the smallest version of this change that will teach us the most?

Not software. The pilot is a templated status email, compiled by one salesperson, sent twice a week, to ten customers β€” the ten who called most during the Observe tally. Thirty days.

The template has three honest states for each open order: shipped (with tracking), confirmed (with the vendor’s ship date), and awaiting vendor confirmation (with the date the company expects to have an answer). That third state exists because the map said it had to. The pilot doesn’t pretend the data is better than it is; it tests whether customers accept honesty on a schedule as a substitute for chasing answers on demand.

Total investment: a template, a checklist, and about ninety minutes of one person’s week.

Exit condition: The pilot has a start date, an end date, a named owner, a defined scope that everyone can state in one sentence, and an agreement about what will be measured β€” before it begins.

Measure

Core question: What did the change actually do β€” including what it broke?

Three numbers, tracked weekly against the Observe baseline: inbound status inquiries from the ten pilot customers, time spent compiling the email, and the count of orders stuck in “awaiting vendor confirmation.”

Two weeks in, the results are mixed in an instructive way. Inquiries from pilot customers drop by more than half β€” most people just wanted to be told without having to ask. But compiling the email takes longer than expected, because the compiler keeps stalling on the same step: hunting for confirmations that may or may not exist in the buyer’s inbox. And several customers reply to the email asking about the awaiting confirmation orders β€” politely moving the same question from the phone to the inbox.

Exit condition: The team can say, with numbers, what improved, what didn’t, and what new friction the change created. “It seems better” doesn’t pass.

Adjust

Core question: What does the feedback say to change before going further?

Two adjustments, both aimed at the friction the pilot surfaced rather than at expanding the pilot:

First, the company assigns ownership of the gap the map found: vendor confirmations get logged the day they arrive, and any purchase order unconfirmed after three business days goes on a chase list that the buyer works every morning. The notification workflow forced the upstream discipline the company had skipped for years.

Second, the awaiting confirmation line in the template gains a promise β€” the date the company will chase the vendor next β€” so the email answers the follow-up question before it’s asked.

Then the loop does what loops do: back to Measure for another two weeks. Inquiries from pilot customers settle at roughly a third of baseline, compile time drops under an hour as the confirmation log fills in, and the stuck-order count starts falling for the first time β€” because someone finally owns it. Expect this Measure–Adjust cycle to run two or three times in a real pass; one clean cycle is the exception, not the rule.

Exit condition: The adjustment addressed the measured friction, the next measurement confirmed it, and the people doing the work agree the workflow is better β€” not just different.

Stabilize

Core question: Is this workflow solid enough to scale, automate, or build on?

Before anyone expands anything, the working version gets written down: the template, the schedule, the three status states, the confirmation-logging rule, the chase list, and who owns each piece. A second salesperson runs the process for a week from the documentation alone, and the gaps that surface get fixed in the document, not in someone’s memory.

Only now does the software conversation reopen β€” and it’s a different conversation. The company is no longer shopping for a tool to solve a mystery. It has a documented, tested, measured workflow, and it needs that workflow to run automatically at full customer scale. The pilot already wrote the requirements list: three status states, a confirmation-data dependency, a chase-list trigger, a twice-weekly cadence. Vendor demos can be judged against reality instead of against hope.

Exit condition: The workflow is documented well enough that someone new can run it, it has an owner, and the decision about what comes next β€” scale it, automate it, or leave it alone β€” is made deliberately. Scaling or automating is a new change, and a new change starts a new pass through the loop.

What One Pass Produced

Thirty-odd days, no software purchased, and the company gained:

  • a measured drop in interruptions;
  • an upstream data-quality fix it didn’t know it needed;
  • a documented and transferable workflow;
  • a requirements list for any future tool;
  • evidence about how change actually lands in this organization, gathered at the cost of a template and a tally sheet.

Compare that to the counterfactual: the notification platform, purchased in month one, faithfully emailing guessed ship dates to every customer. The tool wouldn’t have failed loudly. It would have succeeded at automating the problem.


Common Mistakes

❌ Mistake 1: Starting at Pilot

The trap: “We don’t need to observe anything, we already know what’s wrong.”

The reality: What leadership knows is usually the symptom, not the workflow. Skipping Observe and Map means the pilot tests a guess about the cause instead of the cause itself.

The fix: Spend the two weeks. The pattern that emerges is rarely the one anyone predicted going in.


❌ Mistake 2: Letting the Pilot Grow

The trap: “While we’re at it, let’s roll this out to everyone and add the reporting dashboard too.”

The reality: A pilot that keeps growing stops being a test and becomes a rollout with no baseline to measure against. If it fails, nobody can say why, because too many things changed at once.

The fix: Hold the scope. Write the one-sentence description before the pilot starts, and don’t let anything join it that wasn’t in that sentence.


❌ Mistake 3: Measuring Only the Good News

The trap: “Inquiries are down, the pilot’s a success β€” let’s move to Stabilize.”

The reality: Every real change creates new friction somewhere. A measurement that only tracks the metric leadership wanted to see will miss it β€” until it shows up at full scale, where it’s expensive.

The fix: Measure what the change broke, not just what it fixed. The worked example above found new friction in “compile time” and in customers redirecting the same question to a new channel β€” both true even though inquiries dropped.


❌ Mistake 4: Treating Adjust as Optional

The trap: “The numbers were close enough, let’s call it done.”

The reality: One Measure–Adjust cycle almost never gets a workflow to solid. Stopping early locks in the friction the first pass surfaced but didn’t fix.

The fix: Expect two or three cycles. Budget the time for them before the pilot starts, not after the first measurement disappoints.


❌ Mistake 5: Scaling Before Stabilize

The trap: “It worked for ten customers, so let’s turn it on for all of them.”

The reality: A workflow that only one person can run, from memory, isn’t ready to scale β€” it’s ready to become a bottleneck the moment that person is out sick or leaves.

The fix: Hand the documented process to someone who wasn’t part of building it. If they can’t run it, it isn’t stable yet.


❌ Mistake 6: Buying the Tool to Skip the Loop

The trap: “This is taking weeks. Let’s just buy the platform and let it force the process.”

The reality: A tool can force a process, but not necessarily the right one β€” and it can’t tell you what your organization’s actual handoffs, ownership gaps, or data problems are. Those don’t disappear because software arrived; they get automated.

The fix: The loop is the cheapest way to find out what the tool will actually need to do. Skipping it doesn’t save the work β€” it moves the discovery to after the contract is signed.


This Loop in Practice

I developed this framework by synthesizing recurring patterns from systems analysis and process-improvement work. One earlier example is documented in Specialty Equipment Distribution System Analysis and Transformation Roadmap. That project predated the Measured Change Strategy by several years and did not use its six-stage structure or terminology. It did, however, lead to a closely related sequencing principle:

Stabilize the workflow, clarify ownership, improve the data, and then select or build the technology.

The case study examined an entire information environment: technology, data, workflows, governance, and organizational readiness. Its proposed four-phase roadmap was not implemented during my tenure, so the case study presents the anticipated benefits as projections rather than verified outcomes. The Measured Change Loop carries the same discipline into a smaller, testable unit: one workflow, one change, and evidence gathered before a broader rollout or technology commitment.


When to Use This Loop (and When Not To)

Use it when:

  • A specific workflow has visible friction, but nobody has traced why.
  • A tool purchase is being discussed before the underlying workflow has been mapped.
  • A past attempt to “fix” this workflow didn’t stick, and nobody’s sure why.
  • The change is narrow enough to define in one sentence.

Don’t use it when:

  • The problem is really a department or a strategy, not a workflow. Break it down first.
  • There’s a hard compliance or safety deadline that doesn’t allow for a real pilot window. Some things have to move faster than a loop allows β€” just be honest that speed is being traded for evidence, and plan to Observe retroactively once the deadline passes.
  • The organization has already run this exact loop on this exact workflow recently and nothing meaningful has changed since. Re-running an unchanged loop just delays the decision it already answered.

This is a judgment call, not a formula. The loop produces evidence; it doesn’t remove the need for someone to weigh that evidence against the organization’s actual constraints.


Frequently Asked Questions

What is a workflow improvement framework?

A workflow improvement framework is a structured way to understand how work happens, identify friction, test a change, and evaluate the results. The Measured Change Loop adds explicit exit conditions to each stage so a team knows what evidence it needs before moving from analysis to pilot, rollout, or automation.

How do you test a workflow before buying software?

Start by observing the current process and mapping its handoffs, owners, workarounds, and data dependencies. Then run the smallest pilot that can test the proposed change. Compare the pilot with a documented baseline, adjust the process in response to the evidence, and stabilize the working version before evaluating software against the resulting requirements.

How long should a workflow pilot run?

It should run long enough to capture a representative sample of the work, including normal variations and exceptions. A high-volume workflow may produce useful evidence in a few weeks; a monthly or seasonal process may require a longer pilot. Set the start date, end date, scope, baseline, and measures before the pilot begins.

What should you measure in a workflow pilot?

Measure the outcome the change is supposed to improve and the effort or risk it may shift elsewhere. Useful measures can include cycle time, labor time, error or rework rates, delays, customer inquiries, exceptions, and adoption by the people doing the work. Record what the change disrupted as well as what it improved.

When is a workflow ready for automation?

A workflow is a stronger candidate for automation when it is repeatable, documented, owned, measurable, and supported by reliable data. If the process still depends on undocumented judgment, inconsistent inputs, or one person’s memory, automation may scale those weaknesses instead of solving them.


What Comes After One Pass

Once a workflow has gone through Stabilize, the next decision is usually one of three:

  1. Leave it alone. A stabilized workflow doesn’t have to go anywhere. Some processes are exactly as automated as they need to be.
  2. Scale it. Extend the same documented process to more customers, more teams, or more locations β€” starting a new, faster pass of the loop.
  3. Automate or buy a tool for it. Now the requirements list is real, written by the pilot instead of a vendor’s sales deck, and vendor demos can be evaluated against it directly.

For a broader framework on deciding whether a specific process is ready for AI or automation once it reaches this point, see the AI Readiness Matrix.


Need Help Running a Pass?

If you’re looking at a workflow that feels broken and a vendor demo that looks like the fix, I can help you figure out whether the loop needs to run first β€” and run it with you if it does.

We’ll look at:

  • What the workflow actually does today, versus what it’s supposed to do
  • Where it hands off, stalls, and lacks a clear owner
  • What the smallest real pilot would look like
  • What to measure, and how to tell real improvement from a good feeling

The first conversation is free. We’ll talk through your specific situation, and I’ll tell you honestly whether what I do is the right fit.

β†’ Schedule a Consultation


This framework is part of my independent consulting practice β€” built on independent judgment, transparent relationships, no referral incentives, and evidence-based evaluation. I do not resell software, accept referral fees, or receive commissions for recommending tools. My advisory work is focused on fit, readiness, and practical business value.

Working through a workflow change and not sure it's ready for a tool?

Schedule a free 30-minute consultation to talk through where the change is in the loop β€” and whether it's ready to scale, automate, or needs another pass first.
